Children's Hospital Dublin
South Circular Road Works Phase 1 & Phase 2

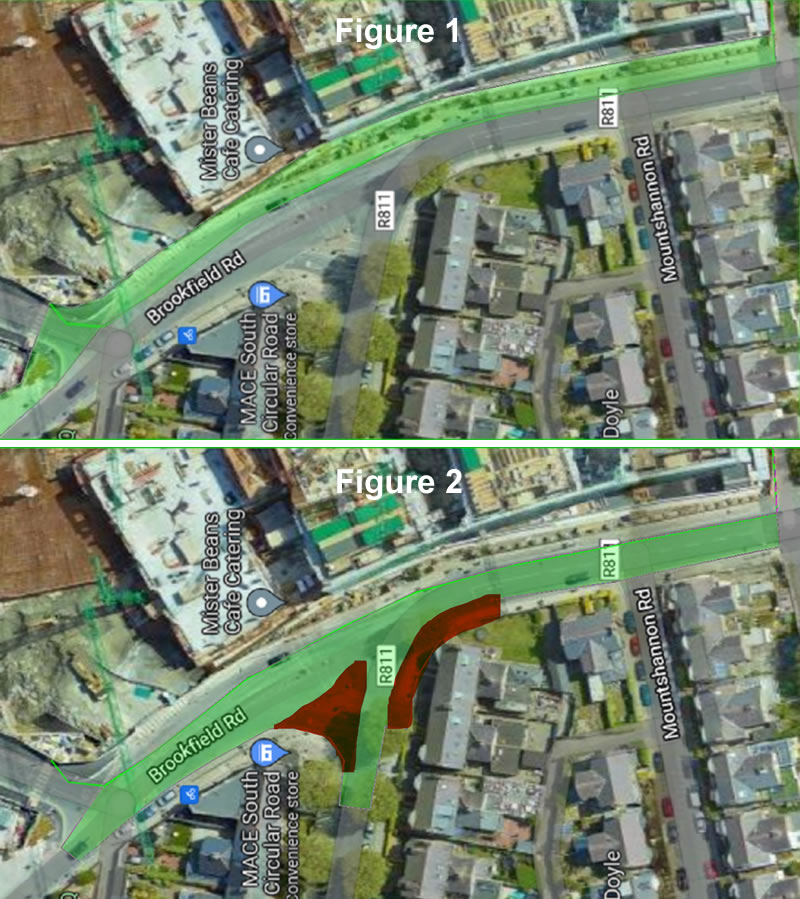

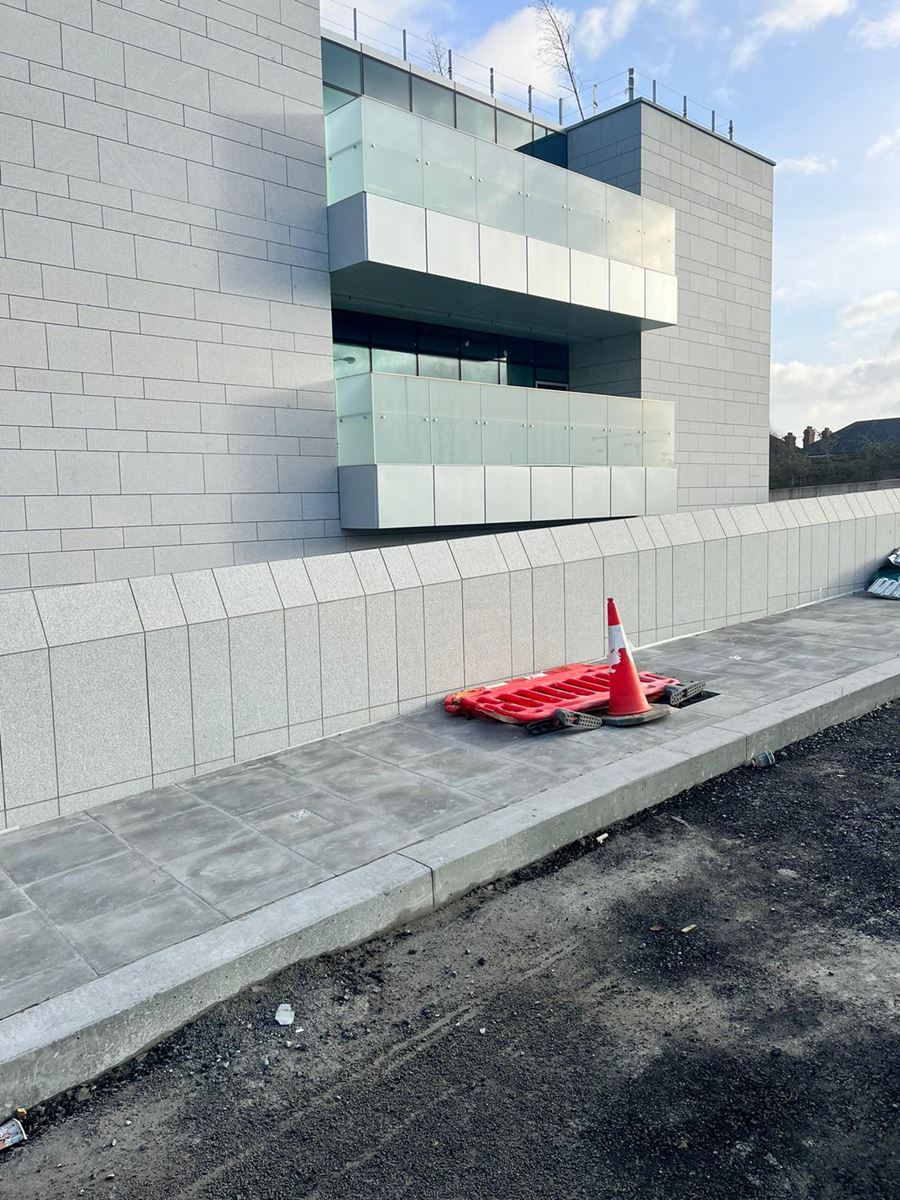

Phase 1 compromises the enabling works to the existing footpath as highlighted indicatively in "Figure 1" attached.
Phase 1 works are summarised as:
• Relocate walking way and install Heras fencing.
• Removal of existing footpath
• Removal of existing kerbing
• Excavation
◦ Removal of existing gullies
◦ Removal of existing main water lines
◦ Removal of existing gas lines
◦ Installation of new services
◦ Reduce level to formation road, footpath, cycling line.
• Construction of new
◦ Kerb lines

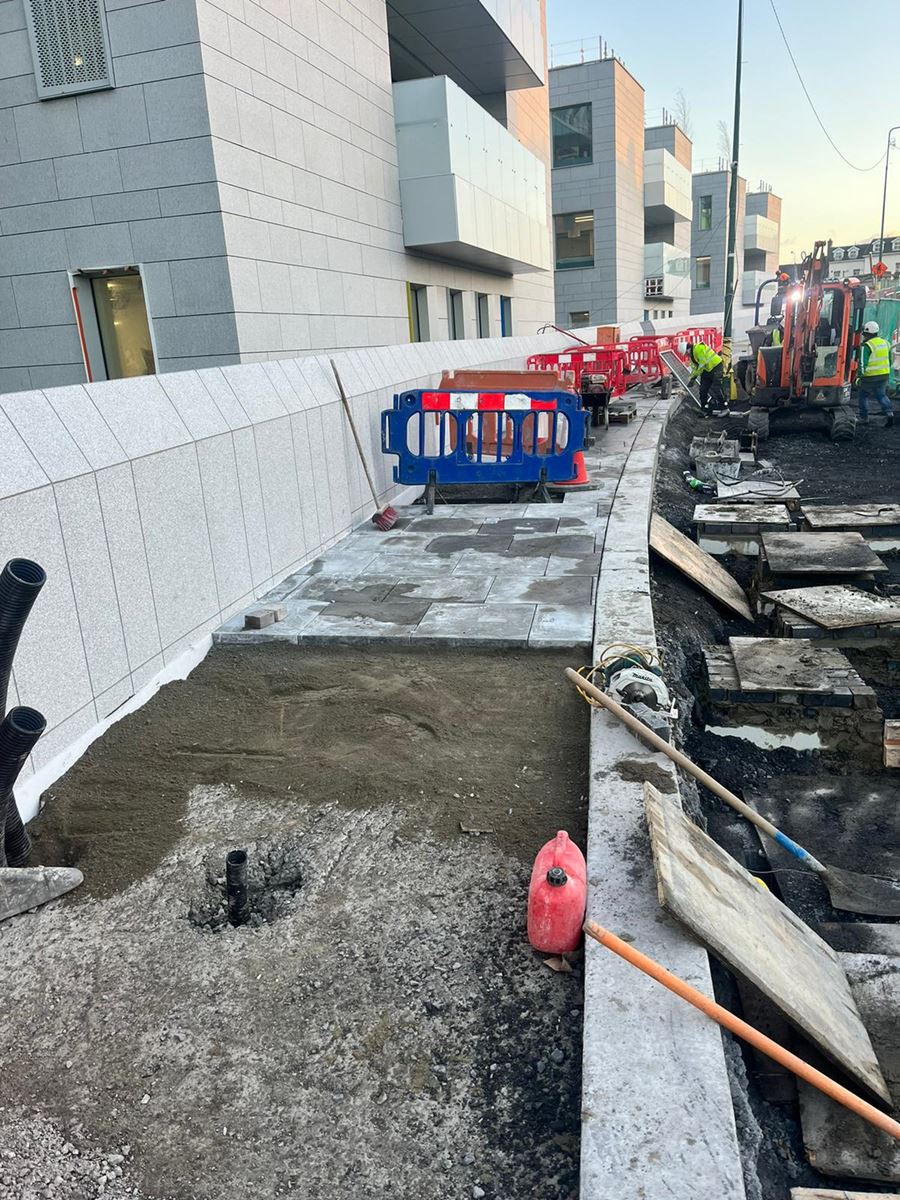

◦ Concrete flags
◦ Chambers
◦ Utilities (Eircom, CCTV, ESB, Storm)
◦ Installation of new watermains

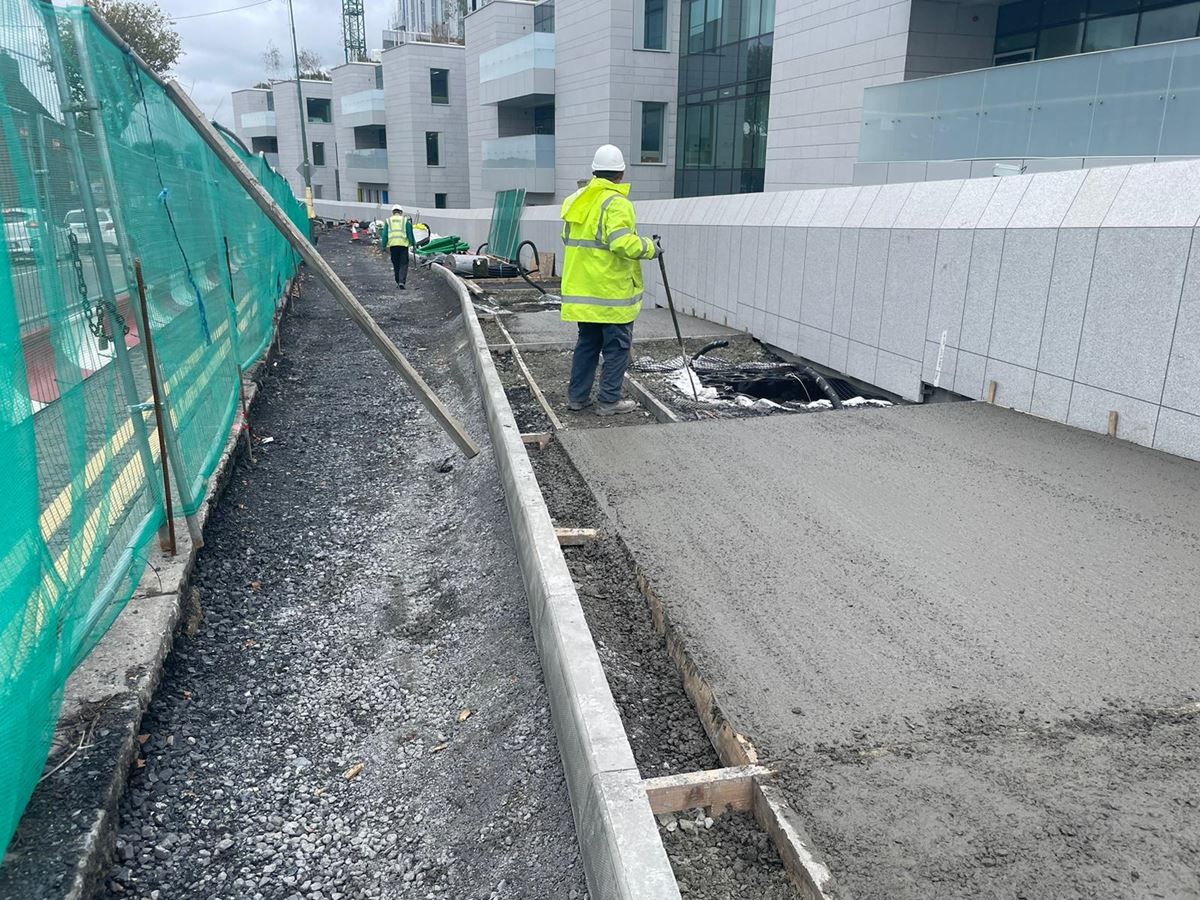

◦ Sub base, Basecourse, Surface course
◦ Diversion of existing services
◦ Traffic lights and ducting installation
• Install new sign poste
• Install new CCTV, pole traffic signal

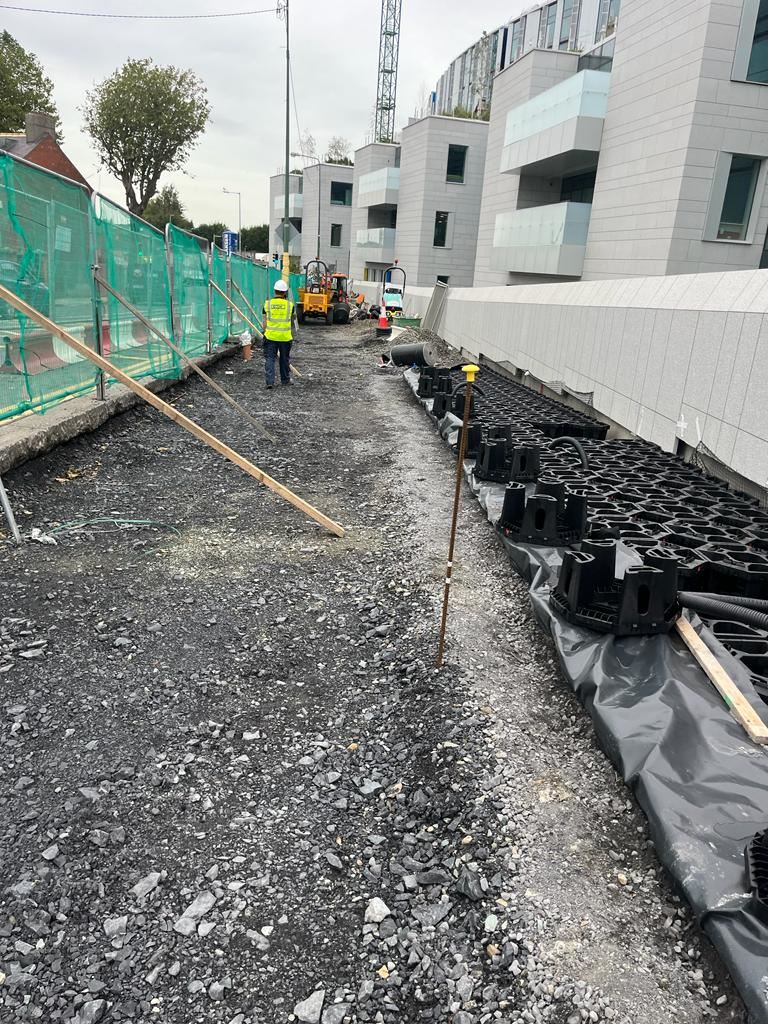

• Install Tree cells
• Traffic management
• Confined space works
Phase 2 compromises the enabling works to the existing footpath as highlighted in red and in the road highlighted in green, indicatively in "Figure 2" attached.
Phase 2 works are summarised as:
• Relocate walking way, replace fence.
• Removal of existing footpath
• Removal of existing kerbing
• Excavation
◦ Installation of new services
◦ Reduce level to formation road, footpath, cycling line.
• Construction of new
◦ Kerb lines
◦ Chambers
◦ Concrete footpath
◦ Utilities (Eircom, CCTV, ESB, Storm)
◦ Traffic lights and ducting installation
◦ Sub base, Basecourse, Surface course
• Install new sign post
• Install new CCTV, pole traffic signal
• Traffic management
